RUITO Header Component
RUITO Basket Strainer - Industrial Filtration Solutions RUITO Hero Module Optimized
Industrial Filtration System

Industrial-grade basket strainers engineered for high-flow applications

Protect Your System. Reduce Downtime. Extend Equipment Life.

20+ Years Manufacturing Excellence
Exported to 60+ Countries

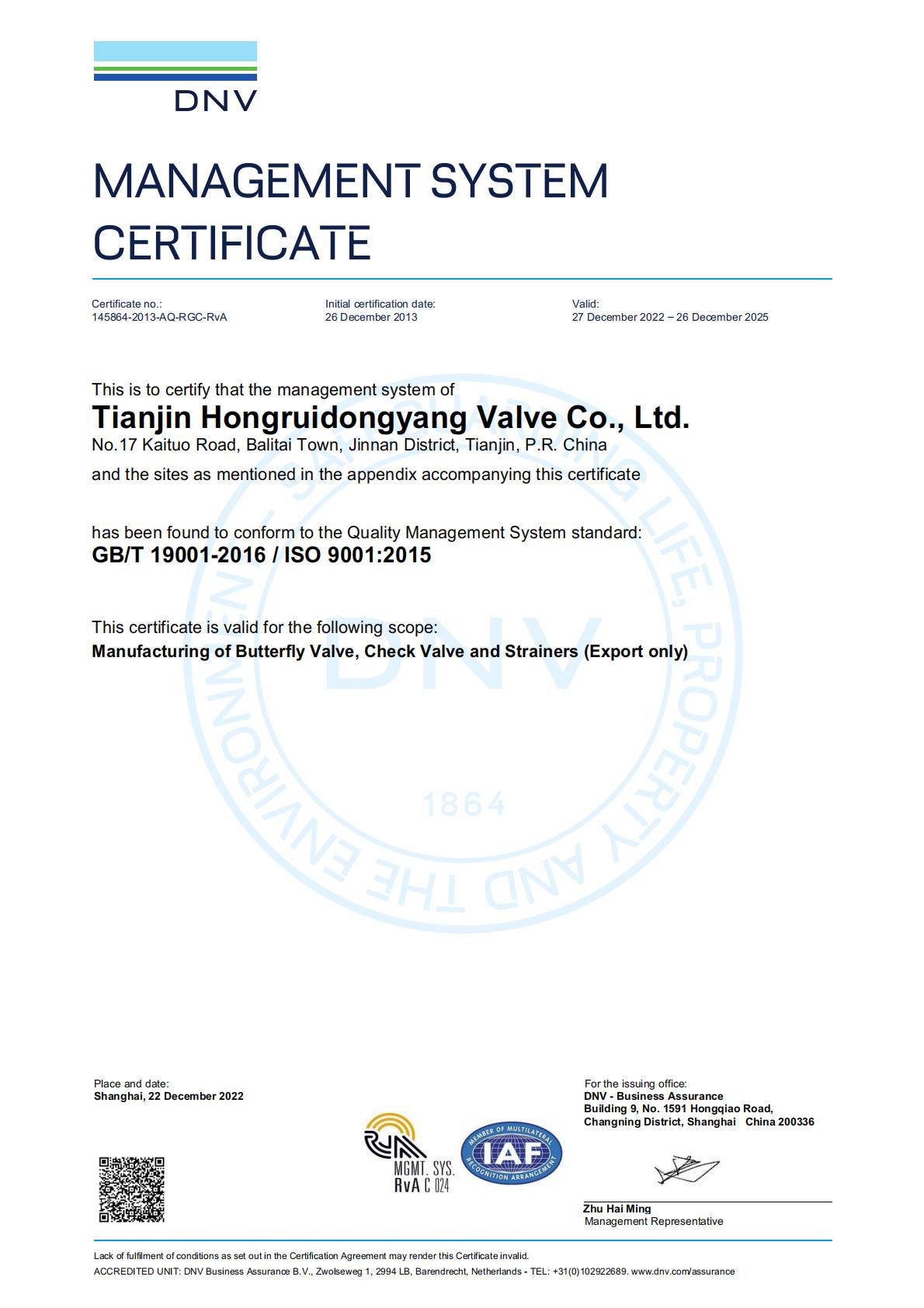

ISO 9001 & CE Certified
RUITO Basket Strainer Detail
RUITO Pain Points Module

Why Pipeline Systems Fail: Six Critical Filtration Risks

Understanding these risks helps you avoid costly equipment damage and production downtime

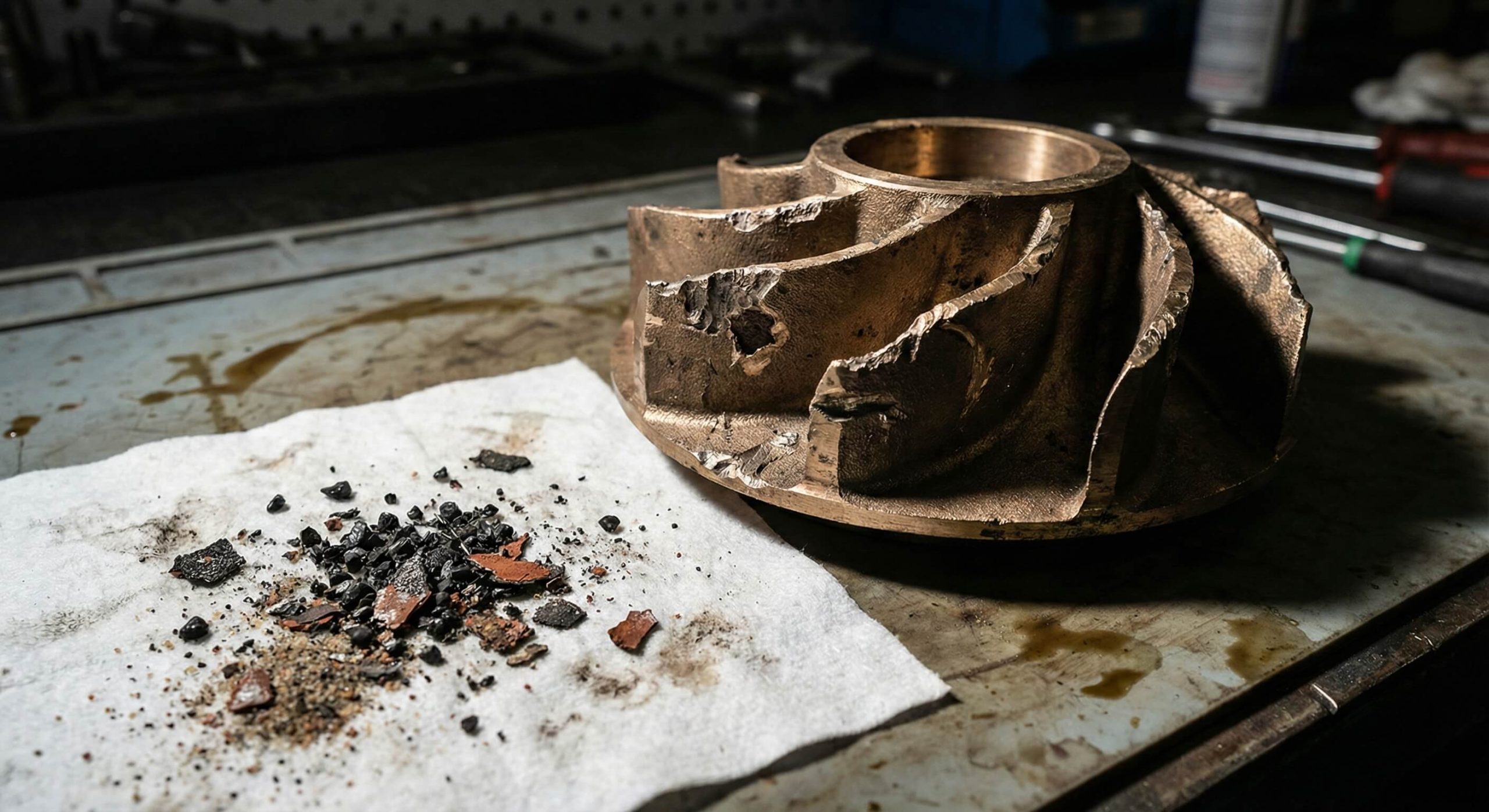

Damaged Pump Impeller

Pump Impeller Damage

Impact: Reduced pump efficiency by 30-50%, increased vibration, premature bearing failure, complete pump replacement required within 6-12 months.

Root Cause: Large debris (welding slag, pipe scale, construction residue) passing through inadequate or bypassed filtration during system startup or maintenance.

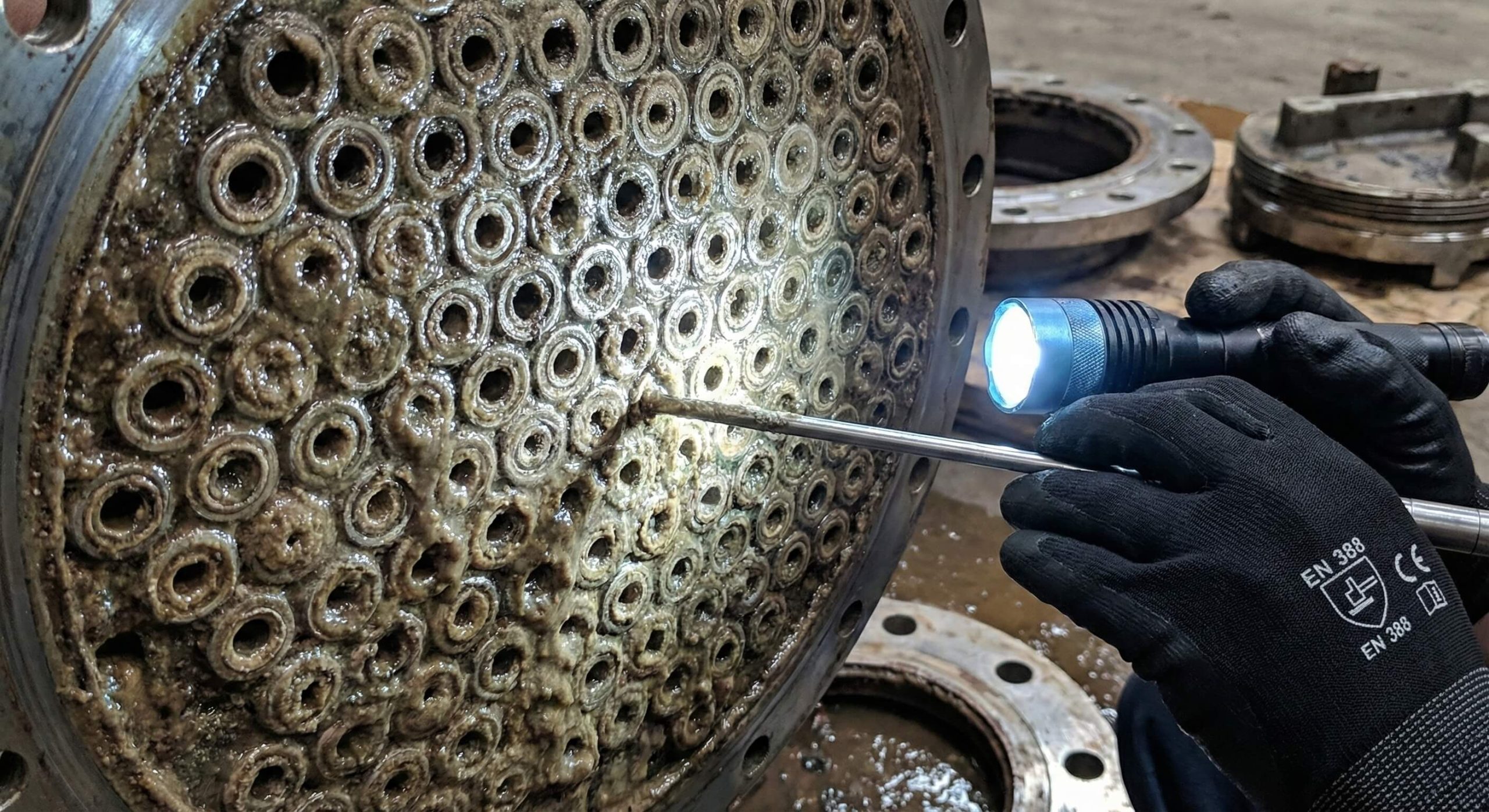

Clogged Pipes

Heat Exchanger Fouling

Impact: Heat transfer efficiency drops 20-40%, energy consumption increases significantly, cleaning frequency rises from yearly to quarterly, potential tube rupture.

Root Cause: Fine particles accumulating in narrow tube passages when filtration mesh size is too coarse or strainer capacity too small for actual debris load.

Seized Control Valve

Control Valve Seizure

Impact: Process control failure, emergency shutdowns, manual override operations, safety incidents, valve replacement costs $5,000-$50,000 per unit.

Root Cause: Hard particles lodging in valve seats and actuator components because strainer is installed too far upstream or mesh holes larger than critical valve clearances.

Emergency Maintenance

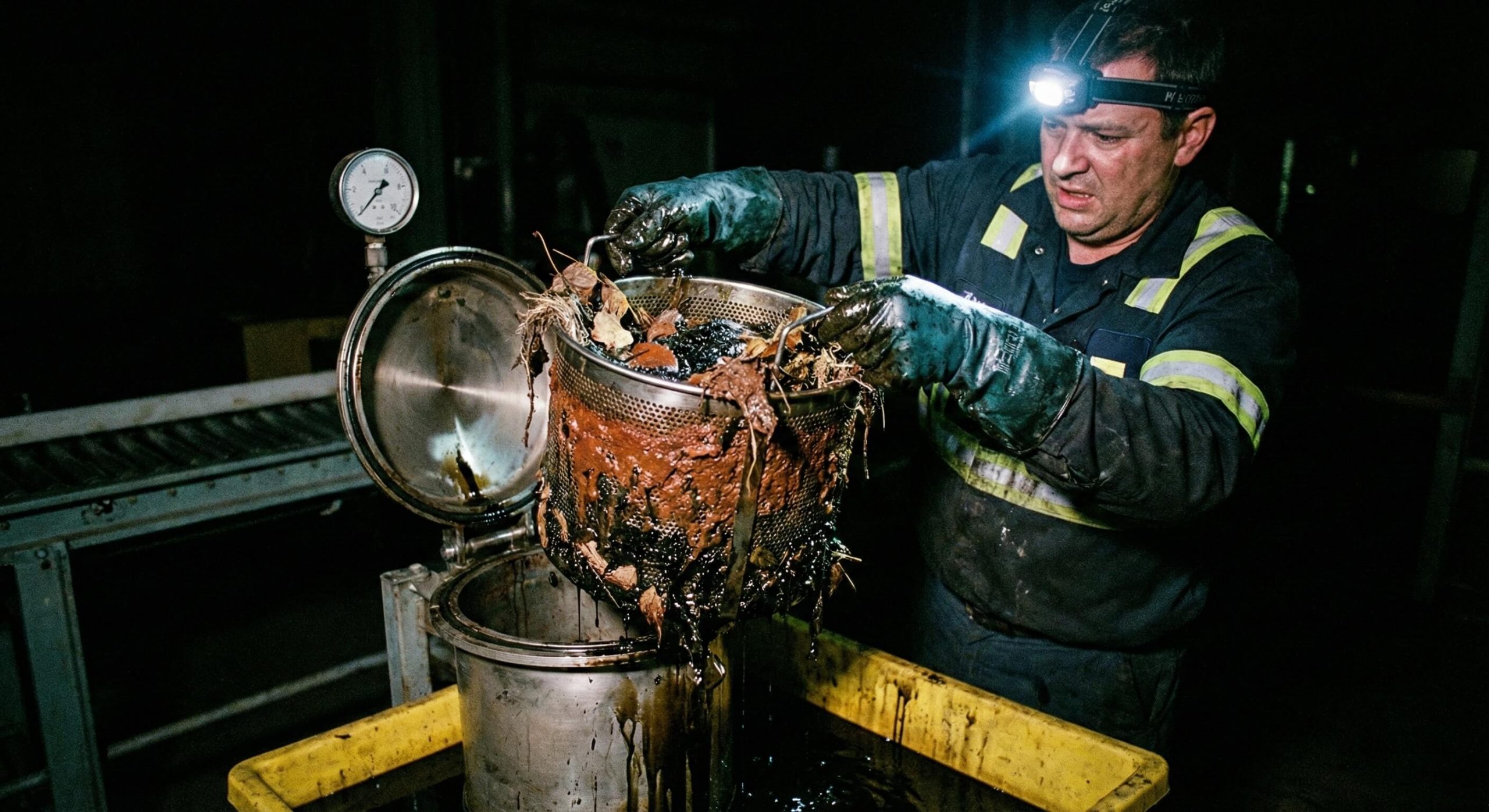

Frequent Emergency Maintenance

Impact: Unplanned production stops 6-12 times/year, 2-4 hour downtime per event, overtime labor costs, missed delivery commitments, customer complaints.

Root Cause: Basket strainer sized only for clean operating conditions without accounting for startup debris loads, seasonal variations, or upstream process changes.

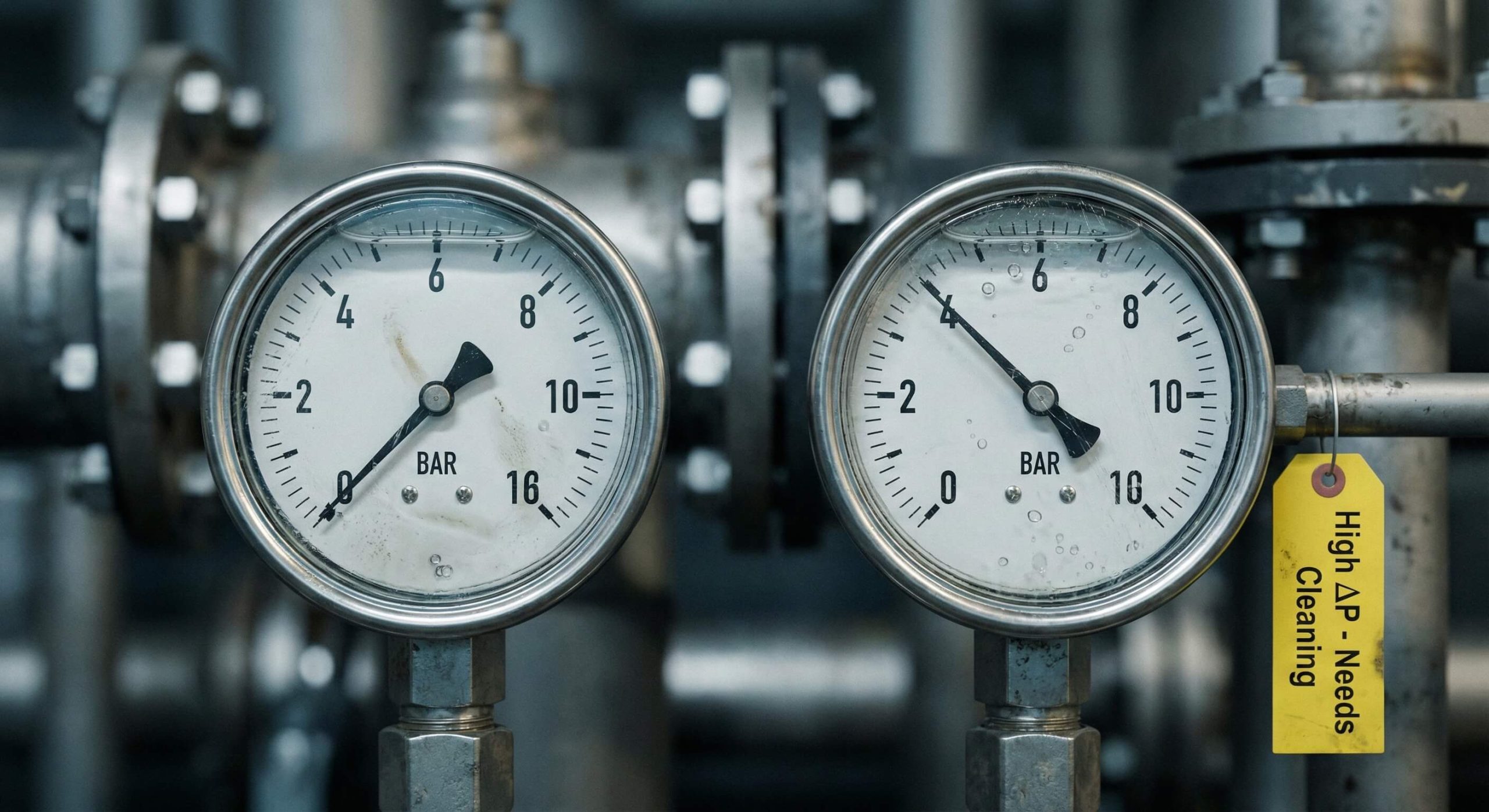

Pressure Gauge

Excessive System Pressure Drop

Impact: Pump energy consumption increases 15-30%, flow rate cannot meet design requirements, additional booster pumps needed, annual energy waste $10,000-$100,000.

Root Cause: Strainer body too small for actual flow rate, basket mesh clogging rapidly, or multiple strainers creating serial resistance in the same line.

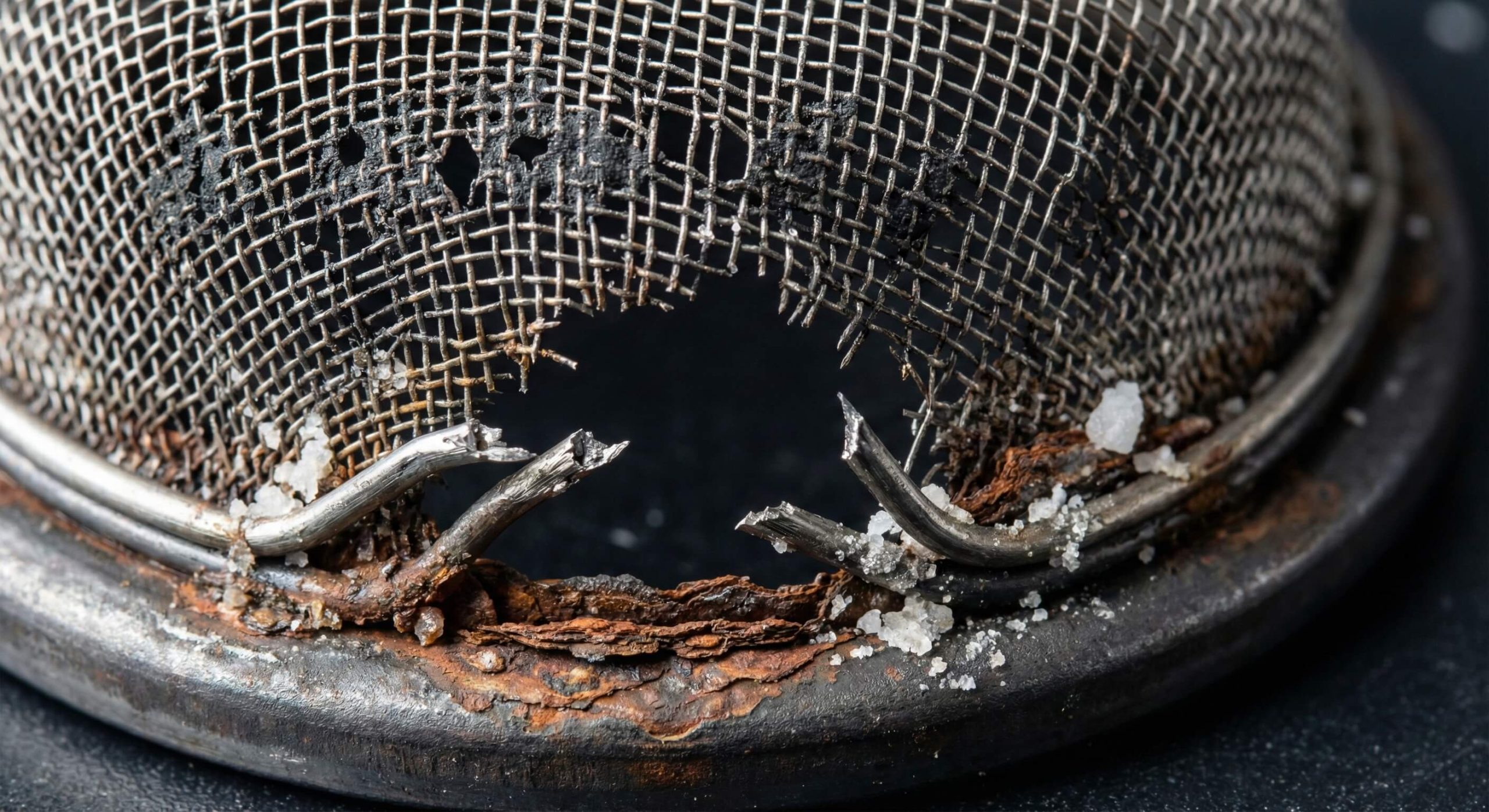

Corrosion

Corrosion-Induced Failure

Impact: Basket perforation causing debris bypass, body wall thinning leading to leaks or rupture, contamination of clean media, complete system compromise.

Root Cause: Wrong material selection (carbon steel in seawater, standard stainless steel in chloride-rich environments), inadequate coating, or galvanic corrosion from dissimilar metals.

Eliminate these risks with properly engineered filtration solutions

Learn Selection Criteria
RUITO Module 3 - Basket vs Y Strainer RUITO Module 3 - Basket vs Y Strainer

Basket Strainer vs Y Strainer: Choosing the Right Tool

Different filtration solutions for different operating requirements — select based on actual application conditions

Basket Strainer Structure

Basket Strainer

High-Flow Applications
  • Large Flow Capacity
    Designed for flow rates above 100 m³/h where Y strainers create excessive pressure drop and frequent clogging.
  • Frequent Maintenance Access
    Quick-opening cover enables cleaning in 5-10 minutes without system disassembly, ideal for heavy debris loads requiring regular service.
  • Low Pressure Drop Performance
    Larger basket volume and optimized flow path maintain pressure drop below 0.3 bar clean, extending time between maintenance cycles.
  • Main Process Lines
    Horizontal installation suited for cooling water systems, primary filtration stages, and applications where vertical space is limited.
  • High Debris Capacity
    Basket volume handles 5-10x more debris than Y strainers before cleaning needed, critical for contaminated media or system startup conditions.
Application Boundary
Y Strainer Structure

Y Strainer

Compact Solutions
  • Small to Medium Flow
    Most cost-effective for flows under 50 m³/h where compact size, lower cost, and simple installation are priorities.
  • Infrequent Cleaning
    Suitable when maintenance intervals can be quarterly or longer, requires system isolation and screen removal for service.
  • Acceptable Pressure Drop
    Smaller screen area results in higher velocity and pressure drop, acceptable in systems with adequate pressure margin and clean media.
  • Branch Lines & Instruments
    Preferred for equipment protection on secondary lines, instrument isolation, and space-constrained installations requiring angular configuration.
  • Clean Media Protection
    Best for relatively clean fluids needing fine filtration where debris accumulation is minimal and does not impact operations.

Need help determining which strainer type fits your application?

Speak with Application Engineer
RUITO Module 4 - Common Mistakes RUITO Module 4 - Common Mistakes (Redesigned) RUITO Module 4 - Common Mistakes (6 Cards)

Why Many Basket Strainers Fail Prematurely

Common misconceptions vs. engineering reality — understanding these differences prevents costly failures

Wrong Assumption

"Strainer size should match pipe size for easy installation and cost savings."

Engineering Reality

Strainer must be sized based on actual flow velocity and debris capacity. A DN100 pipe at high flow may require DN150 strainer to maintain velocity below 3 m/s and prevent rapid clogging.

Wrong Assumption

"Finer mesh is always better — it catches more debris and protects equipment better."

Engineering Reality

Mesh size must match downstream equipment requirements. Too fine mesh (e.g., 40 mesh for cooling water) clogs in hours. Pump protection typically needs 20-40 mesh; control valves need 80-100 mesh.

Wrong Assumption

"Stainless steel is corrosion-proof — one grade works for all applications."

Engineering Reality

Material selection must account for specific corrosive agents. SS304 fails in chloride-rich environments within 1-2 years. SS316L is minimum for marine. Dissimilar metals accelerate galvanic corrosion.

Wrong Assumption

"Lower pressure rating is acceptable because our system never reaches design pressure."

Engineering Reality

Rating must account for water hammer, thermal expansion, and safety margins. Systems operating at 10 bar can experience 20-30 bar transients. Thin flanges leak under thermal cycling.

Wrong Assumption

"Standard off-the-shelf strainer is good enough — customization adds unnecessary cost."

Engineering Reality

Critical applications require solutions matching actual conditions. Real systems may need DP gauges, lifting lugs, or special coatings. Initial cost prevents failures costing 10-100x more.

Wrong Assumption

"Basket strainers can be installed in vertical piping just like Y-strainers."

Engineering Reality

Basket strainers are engineered for horizontal pipelines. Vertical installation often traps debris against the cover, causing it to fall back into the line during maintenance, or prevents proper drainage.

Avoid these costly mistakes with engineering-based strainer selection

See RUITO Design Approach

Correct Selection Logic: Three-Layer Decision Framework

Each layer addresses different failure modes — skipping any layer increases project risk

1

System Level — Define Operating Envelope

Operating Conditions
Media type, contamination level, seasonal variation
Flow Requirements
Design flow, peak flow, minimum flow, velocity limits
System Integration
Upstream/downstream equipment, bypass availability
DECISION OBJECTIVE

Determine if basket strainer is appropriate versus Y-strainer, automatic strainer, or dual-basket configuration

CONSEQUENCE OF ERROR

Wrong strainer type leads to frequent clogging, excessive pressure drop, or inability to perform maintenance without shutdown

2

Engineering Level — Calculate Critical Parameters

Pressure & Temperature
Design pressure, test pressure, max temperature
Hydraulic Design
Allowable pressure drop, clean vs. dirty differential
Maintenance Frequency
Cleaning interval, inspection access, spare parts strategy
DECISION OBJECTIVE

Calculate strainer body size, basket volume, and performance envelope to ensure adequate capacity with safety margins

CONSEQUENCE OF ERROR

Undersized strainer causes rapid fouling requiring daily cleaning; overpressure leads to gasket failure and leaks; wrong material fails under thermal stress

3

Product Level — Specify Detailed Configuration

Structural Design
Cover type, flange standard, support arrangement
Material Selection
Body material, basket alloy, coating requirements
Basket Specification
Mesh size, perforation type, handle design, coating
DECISION OBJECTIVE

Finalize exact product specification including all accessories, testing requirements, and quality documentation needed for procurement

CONSEQUENCE OF ERROR

Wrong flange standard causes field modifications and delays; incorrect mesh damages downstream equipment; missing accessories prevent proper operation and maintenance

Let our engineers guide you through this selection process with application-specific recommendations

Request Engineering Support
RUITO Basket Strainer - Modules 6-10 RUITO Module 6 - Design Philosophy

RUITO Basket Strainer Design Philosophy

Six engineering solutions addressing real system problems — not generic catalog products

SYSTEM PROBLEM

Excessive pressure drop reducing pump efficiency and increasing energy costs

RUITO DESIGN SOLUTION

Optimized flow path geometry: Internal baffle design eliminates turbulence zones, streamlined inlet/outlet reduces velocity head loss by 40%, oversized basket screen area maintains low approach velocity under 2 m/s even at peak flow.

ENGINEERING RESULT

Clean pressure drop below 0.1 bar, dirty differential extended from 0.5 to 1.2 bar before cleaning required, pump energy savings 15-25%

SYSTEM PROBLEM

Rapid basket clogging forcing daily maintenance shutdowns and production losses

RUITO DESIGN SOLUTION

Maximized filtration surface area: Deep basket design provides 3-5x more screen area than standard models, dual-layer mesh construction separates coarse and fine debris, self-cleaning flow pattern prevents premature blinding.

ENGINEERING RESULT

Maintenance intervals extended from daily to weekly or monthly, debris holding capacity increased 400%, unplanned shutdowns reduced by 80%

SYSTEM PROBLEM

Time-consuming maintenance requiring system shutdown and extensive disassembly

RUITO DESIGN SOLUTION

Quick-access cover mechanism: Hinged or swing-bolt cover opens in 30 seconds without tools, ergonomic basket handle enables one-person removal even when fully loaded, integrated drip tray prevents floor contamination during cleaning.

ENGINEERING RESULT

Cleaning cycle reduced from 45 minutes to 5-8 minutes, single operator can maintain strainer safely, downtime per maintenance event decreased 85%

SYSTEM PROBLEM

Corrosion causing basket perforation, body leaks, and complete system failure

RUITO DESIGN SOLUTION

Application-matched materials: SS316L for marine/chloride environments, duplex stainless for high-strength seawater service, carbon steel with fusion-bonded epoxy for cost-effective freshwater applications, compatibility testing prevents galvanic corrosion between components.

ENGINEERING RESULT

Service life extended from 2-3 years to 15-20 years, zero corrosion-related failures in warranty period, maintenance limited to gasket replacement only

SYSTEM PROBLEM

Seal and gasket failures causing leaks, environmental contamination, and safety hazards

RUITO DESIGN SOLUTION

Robust sealing system: Machined sealing surfaces within 0.05mm flatness tolerance, groove-captured gaskets prevent extrusion under pressure cycling, material selection based on temperature/chemical compatibility (EPDM/Viton/PTFE/graphite), safety factor 2x on compression loads.

ENGINEERING RESULT

Leak-free operation over 500 open/close cycles, gasket life extended to 3-5 years under normal service, zero fugitive emissions in chemical service

SYSTEM PROBLEM

Structural failure or deformation under thermal cycling and pressure transients

RUITO DESIGN SOLUTION

Engineered mechanical integrity: FEA-verified body wall thickness with 1.5x safety margin per ASME Section VIII, reinforced nozzle connections prevent stress concentration, thermal expansion analysis ensures flange alignment maintained -20°C to +200°C, hydrostatic testing to 1.5x design pressure on every unit.

ENGINEERING RESULT

Zero structural failures over 20+ year operational history, maintains alignment through 10,000+ thermal cycles, certified for shock loads from water hammer events

See how these design principles translate into specific product series for your application

View Product Series

Product Series Classification

Six specialized series engineered for distinct applications — choose based on your operating conditions

Standard Cast Iron Series

Standard Cast Iron Series

General Purpose

Cooling water systems, HVAC applications, non-corrosive liquids at ambient temperatures in municipal and commercial facilities

Cost-effective solution for clean to moderately dirty water
Epoxy coating option extends life to 10+ years
Wide size range DN50-DN600 with bolted or hinged covers
Carbon Steel Series

Carbon Steel Series

High Pressure

Steam condensate, boiler feedwater, industrial process water requiring ASME B16.34 Class 150-600 pressure ratings

Pressure capability up to PN100 (Class 600) for critical systems
Temperature range -29°C to +425°C with appropriate gaskets
Internal coating options for corrosion protection without premium alloys
SS304 Series

SS304 Series

Food & Pharma

Drinking water, food processing, pharmaceutical production, beverage industries requiring sanitary design and corrosion resistance

Sanitary finishes available: electropolish to Ra 0.4μm for cleanability
FDA-compliant materials with material certificates traceable to heat
Tri-clamp connection options for CIP systems and frequent cleaning
SS316L Series

SS316L Series

Marine & Chemical

Seawater, brackish water, chemical processing, coastal facilities where chloride-induced corrosion is primary concern

Superior pitting resistance in chloride-rich environments (PREN >24)
Proven 15-20 year service life in continuous seawater duty
Low carbon grade prevents weld decay and intergranular corrosion
Duplex Stainless Series

Duplex Stainless Series

Extreme Duty

Offshore platforms, desalination plants, high-velocity seawater requiring both corrosion resistance and mechanical strength

Yield strength 2x higher than austenitic grades for thinner walls
Exceptional stress corrosion cracking resistance in hot chlorides
Cost-effective alternative to super austenitic or nickel alloys
Special Lined Series

Special Lined Series

Corrosive Media

Strong acids, alkalis, slurries where metallic construction alone cannot provide adequate corrosion protection

PTFE/PFA lining for aggressive chemicals (pH 0-14, temp to 180°C)
Rubber lining options for abrasive slurries and particle-laden fluids
Carbon steel body with specialty lining reduces cost vs. exotic alloys

Unsure which series matches your application? Our technical team provides free material selection guidance

Get Material Recommendation

Technical Parameters Overview

Standard specification ranges — custom configurations available for special applications

Size Range
DN15 (1/2") to DN600 (24") | Flange connections per ASME B16.5, DIN/EN 1092, JIS B2220
Pressure Rating
PN10/16/25/40/63/100 (DIN) | Class 150/300/600 (ASME) | Custom ratings available to ASME Section VIII Division 1
Temperature Range
-29°C to +425°C depending on material and gasket selection | Standard service -10°C to +120°C
Mesh Options
Perforated: 3mm-10mm holes | Wire mesh: 20 to 150 mesh | Dual-layer: Coarse outer + fine inner
Body Materials
Cast iron: ASTM A126 Class B | Carbon steel: WCB, A105 | Stainless: CF8M, CF8, Duplex 2205 | Alloys: Hastelloy, Monel
Basket Materials
SS304/SS316L (standard) | Duplex stainless (marine) | Monel/Hastelloy (chemical) | Plastic-coated
Gasket Options
Standard: EPDM, NBR | Chemical: Viton (FKM), PTFE | High Temp: Graphite, Spiral Wound | Food: Silicone
Cover Design
Bolted: All sizes/pressures | Quick-opening hinged: DN50-DN300 | Swing-bolt: Rapid access for DN80-DN400
Design Standards
ASME B16.34 | ASME Section VIII Div. 1 | EN 13445 | GB150
Testing Requirements
Hydrostatic: 1.5x design pressure | Pneumatic | PMI testing | Witness testing available
Coating Options
Internal: FBE, liquid epoxy, PTFE lining | External: Epoxy + PU topcoat, Galvanizing | Thickness: 250-500 microns
Optional Accessories
DP gauges/switches, Magnetic level indicators, Drain/Vent valves, Davit arms, Sight glasses, Insulation jackets

Need detailed specifications or a custom configuration? Request our complete technical datasheet

Download Technical Datasheet

Material & Media Compatibility Matrix

Select materials based on actual media characteristics — wrong selection leads to premature failure

Media Type
Cast Iron + Epoxy
Carbon Steel + Coating
SS304
SS316L
Duplex / Special
Drinking Water / Fresh Water
Recommended
Recommended
Recommended
Acceptable
Over-spec
Seawater / Brackish Water
Not Suitable
Not Suitable
Not Suitable
Recommended
Recommended
Mild Chemicals (pH 6-9)
Case by Case
With Lining
Recommended
Recommended
Over-spec
Strong Acids / Alkalis
Not Suitable
With PTFE Lining
Limited Use
Case by Case
Recommended
Cooling Water (Open Loop)
Recommended
Recommended
Recommended
Over-spec
Over-spec
Slurries / Abrasive Media
With Rubber Lining
With Rubber Lining
Acceptable
Recommended
Recommended
Recommended Optimal choice for long service life and reliability
Acceptable Functional but may have limitations or require special treatment
Not Recommended High risk of failure or significantly reduced service life

Have a complex or aggressive media? Send us your process data for detailed material analysis

Request Material Analysis

Project Risk Mitigation: RUITO vs Generic Suppliers

Five critical risk dimensions where supplier selection directly impacts project success

Technical Risk

COMMON SUPPLIER ISSUES
  • Generic catalog selection without engineering analysis of actual operating conditions
  • No pressure drop calculations or verification of adequate basket volume for debris load
  • Material selection based on price rather than corrosion mechanism and service life
  • Inability to provide design calculations, FEA analysis, or ASME U-stamp certification
  • Limited technical support after sale — no troubleshooting assistance for operational issues
RUITO RISK MITIGATION
  • Application engineering review: Flow calculations, sizing verification, material compatibility analysis before quotation
  • Design validation: FEA for custom configurations, pressure drop modeling, thermal expansion analysis when required
  • Code compliance: ASME Section VIII calculations, stamping available, third-party inspection coordination
  • Material traceability: Mill certificates, PMI testing reports, heat number tracking for critical components
  • Ongoing technical support: Field troubleshooting, performance optimization recommendations, retrofit engineering if needed

Delivery Risk

COMMON SUPPLIER ISSUES
  • Unrealistic lead times quoted during sales phase, actual delivery 2-3x longer than promised
  • No production planning or capacity management — orders processed first-come-first-served
  • Material procurement delays not communicated until after order placement and deposit paid
  • Production bottlenecks during busy seasons with zero contingency planning or expedite options
  • Shipment delays blamed on freight forwarders with no proactive tracking or problem resolution
RUITO RISK MITIGATION
  • Realistic scheduling: Lead times based on actual production capacity and current workload, not theoretical minimums
  • Material inventory: Stock of common sizes and materials for faster turnaround on standard configurations
  • Production tracking: Weekly progress updates during manufacturing, photo documentation at key milestones
  • Expedite capability: Dedicated fast-track production line for urgent orders with premium service fee
  • Logistics management: Coordinated shipping arrangements, tracking numbers provided, customs documentation support

Documentation Risk

COMMON SUPPLIER ISSUES
  • Generic operation manuals not specific to ordered configuration or materials of construction
  • Test certificates with incomplete data, illegible stamps, or questionable authenticity for inspections
  • Material certificates not traceable to actual heats used in production — copied from previous orders
  • Missing dimensional drawings, assembly procedures, or spare parts lists for maintenance planning
  • No fabrication records, welding procedures, or quality control data for regulatory audits or insurance claims
RUITO RISK MITIGATION
  • Complete technical documentation: As-built drawings, material specifications, test reports specific to each order
  • Traceable certifications: Material certificates with heat numbers, PMI test reports, coating DFT measurements
  • Quality records package: Hydrostatic test reports, welding procedures (WPS/PQR), inspection checklists with signatures
  • Operating instructions: Installation guidelines, commissioning procedures, maintenance schedules, troubleshooting guide
  • Digital documentation: PDF and CAD file delivery, document revision control, access to technical library portal

Quality Risk

COMMON SUPPLIER ISSUES
  • Inconsistent manufacturing quality — each batch differs in dimensions, finish, and component fit
  • Material substitution without notification to reduce costs (SS304 instead of SS316L, for example)
  • Poor welding quality with porosity, undercut, or lack of fusion discovered during field installation
  • Inadequate surface preparation before coating leading to premature delamination and corrosion
  • No incoming material inspection or process controls — defects discovered only at final assembly or worse, in service
RUITO RISK MITIGATION
  • ISO 9001 quality system: Documented procedures for all manufacturing steps, regular internal and external audits
  • Material verification: PMI testing on all stainless/alloy materials, certificates checked against actual heats used
  • Certified welders: AWS/ASME qualified personnel, procedure qualification records maintained, weld maps for traceability
  • Multi-stage inspection: Raw material receiving, in-process checks, final dimensional verification, 100% pressure testing
  • Third-party inspection: Customer witness points available, independent inspection agencies coordinated at no extra charge

Communication Risk

COMMON SUPPLIER ISSUES
  • Language barriers causing misunderstanding of technical requirements and project specifications
  • Time zone differences with no overlap for real-time discussion — email responses take 24-48 hours
  • Sales contact disappears after order placement — no dedicated project manager or technical liaison
  • Technical questions routed through multiple people creating delays and information loss in translation
  • Critical issues not escalated properly — problems discovered only when equipment arrives damaged or wrong
RUITO RISK MITIGATION
  • Technical fluency: Engineering team with strong English communication, understands international standards and project requirements
  • Dedicated support: Single point of contact throughout project lifecycle from quotation through commissioning
  • Responsive communication: Email replies within 24 hours, urgent issues addressed same business day, video calls scheduled as needed
  • Proactive updates: Weekly progress reports during manufacturing, immediate notification of any delays or technical questions
  • Documentation clarity: Technical drawings and specifications in English with metric and imperial units, interpretation support available

Experience the RUITO difference — let us demonstrate how we mitigate project risks from inquiry to delivery

Start Your Project

Project Case Studies

Real engineering challenges solved — outcomes validated by years of continuous operation

Offshore Platform
PROJECT BACKGROUND

Offshore Oil Platform — North Sea, Norway | Seawater cooling system for gas compression equipment operating 24/7 in harsh marine environment with high biological fouling load and seasonal debris variations.

CRITICAL RISK FACTORS

Existing Y-strainers clogging every 6-8 hours requiring production shutdown for cleaning. High chloride environment causing SS304 basket corrosion and perforation within 18 months. Pressure drop exceeding design limits affecting compressor cooling capacity.

RUITO SOLUTION PROVIDED

Supplied DN300 duplex stainless 2507 basket strainer with oversized basket (5x surface area vs. original Y-strainer), dual-layer mesh (coarse outer for seaweed, fine inner for shells), quick-opening swing-bolt cover for 10-minute cleaning cycles.

VERIFIED PROJECT OUTCOME

Operating continuously since 2018 (6+ years) with zero corrosion issues. Cleaning interval extended to 48-72 hours reducing maintenance labor by 85%. Pressure drop maintained below 0.3 bar eliminating compressor thermal trips.

Chemical Plant
PROJECT BACKGROUND

Chemical Plant — Middle East | Concentrated sulfuric acid (98%) filtration protecting critical metering pumps in fertilizer production facility with high process uptime requirements and strict safety protocols.

CRITICAL RISK FACTORS

Standard SS316L strainer failed catastrophically within 3 months due to localized corrosion at welds. Generic PTFE-lined carbon steel units suffered lining delamination from thermal cycling. Previous supplier could not provide proper material certificates.

RUITO SOLUTION PROVIDED

Engineered DN80 Hastelloy C-276 basket strainer with full penetration TIG welding per ASME IX, PFA-lined basket for chemical inertness, extended bonnet design for thermal isolation, complete documentation package including NACE MR0175 compliance.

VERIFIED PROJECT OUTCOME

Operational since 2019 (5+ years) with zero material degradation confirmed by periodic ultrasonic thickness testing. Eliminated unplanned maintenance events saving $180,000 annually in production losses.

Desalination Plant
PROJECT BACKGROUND

Desalination Plant — United Arab Emirates | Seawater intake filtration for 50,000 m³/day SWRO facility protecting high-pressure pumps and membrane systems with stringent particle size requirements below 100 microns.

CRITICAL RISK FACTORS

Extreme debris load during seasonal storms requiring cleaning every 4-6 hours. Existing automatic backwash strainers experiencing frequent control system failures. High salinity (45,000 ppm TDS) combined with 35°C water temperature accelerating corrosion.

RUITO SOLUTION PROVIDED

Delivered dual DN600 SS316L basket strainers in parallel configuration enabling continuous operation during cleaning, 100-mesh baskets with 12 m² total filtration area, differential pressure transmitters with PLC integration, davit arms for safe basket handling.

VERIFIED PROJECT OUTCOME

Commissioned 2020, operating reliably through 4 storm seasons. Alternating basket cleaning maintains uninterrupted flow with zero pump trips. Particle removal efficiency consistently >99.5% protecting downstream RO membranes.

Power Plant
PROJECT BACKGROUND

Power Generation Plant — Southeast Asia | Cooling water system for 500MW combined-cycle gas turbine plant using river water with high sediment load during monsoon season and organic debris from upstream agricultural activity.

CRITICAL RISK FACTORS

Cast iron strainers corroding through in 2-3 years requiring complete replacement. Inadequate basket volume causing cleaning frequency to spike from weekly to twice-daily during monsoon. Poor gasket design leading to fugitive emissions.

RUITO SOLUTION PROVIDED

Manufactured 8 units DN800 carbon steel strainers with 600μm fusion-bonded epoxy lining, extra-deep baskets providing 400% more debris capacity, groove-captured EPDM gaskets eliminating extrusion risk, position indicator switches confirming proper closure.

VERIFIED PROJECT OUTCOME

Installed 2017, all units remain in service with coating integrity >95%. Cleaning frequency stabilized at 2-3 times weekly even during peak monsoon periods, 70% reduction vs. previous system. Zero leak incidents over 7+ years operation.

Facing similar challenges? Share your application details for an engineered solution

Discuss Your Project

Manufacturing Process Flow

Complete production chain with integrated quality verification at each critical stage

1

Casting

PROCESS OUTPUT

Raw strainer body and cover castings with dimensional tolerances within ASTM A126 Class B or EN-GJL-250 specifications, controlled microstructure free from porosity and inclusions.

MANUFACTURING CAPABILITY

Sand casting furnaces with spectroscopic analysis for composition control | Pattern library covering DN15-DN600 standard sizes | X-ray inspection capability.

Foundry Casting Process
2

Machining

PROCESS OUTPUT

Precision-machined flange faces, bore diameters, and sealing surfaces meeting ASME B16.5 dimensional requirements with surface finish Ra 3.2μm or better for reliable gasket seating.

MANUFACTURING CAPABILITY

CNC machining centers with 4-axis capability for complex geometries | CMM inspection for dimensional verification | Surface roughness measurement on critical seal surfaces.

CNC Machining Center
3

Surface Treatment

PROCESS OUTPUT

Corrosion-resistant coating system applied to specification: fusion-bonded epoxy, liquid epoxy, or specialized linings achieving target DFT thickness uniformity and adhesion strength.

MANUFACTURING CAPABILITY

Shot blasting equipment for Sa 2.5 surface preparation per ISO 8501 | Powder coating line with curing ovens | DFT gauges for quality verification.

Industrial Coating Process
4

Assembly

PROCESS OUTPUT

Complete strainer assembly with basket installed, gaskets positioned correctly, fasteners torqued to specification, all accessories (gauges, drains, vents) mounted.

MANUFACTURING CAPABILITY

Torque-controlled assembly tools ensuring proper bolt loading | Basket fabrication shop with wire mesh welding | Component inventory traceability.

Product Assembly
5

Testing

PROCESS OUTPUT

Pressure integrity verified through hydrostatic testing at 1.5x design pressure, leak-free performance confirmed, test reports documenting pressure hold time and acceptance.

MANUFACTURING CAPABILITY

Dedicated test bench with calibrated pressure gauges | Multiple test configurations for different sizes | Witness test coordination available.

Pressure Testing
6

Packing

PROCESS OUTPUT

Protected units ready for shipment with flange faces covered, internal preservation applied, impact-resistant packaging meeting ISPM 15 export requirements.

MANUFACTURING CAPABILITY

Custom crating capability for oversized units | VCI preservation materials for marine transport | Shipping documentation preparation.

Export Packing

Want to see our manufacturing facility? We welcome customer factory audits and inspections

Schedule Factory Visit

Quality Gates & Testing Protocol

Six verification checkpoints ensuring conformance before release — failures caught early prevent field issues

Material Inspection PMI

Gate 1: Raw Material Receiving

VERIFICATION ITEMS

Material certificates match order, PMI testing confirms alloy composition, dimensional check on raw stock, coating batch testing.

RISK IF SKIPPED

Wrong grade (e.g., SS304 vs SS316L) causing premature corrosion; loss of heat traceability preventing root cause analysis.

RUITO CONTROL METHOD

Handheld XRF analyzer for composition verification | Certificate review checklist | Quarantine area for non-conformance.

Casting Inspection

Gate 2: Casting Verification

VERIFICATION ITEMS

Visual inspection for defects, dimensional check vs pattern, internal soundness via X-ray/UT, test bar composition analysis.

RISK IF SKIPPED

Porosity causing leaks under pressure, dimensional deviations stopping assembly, brittle microstructure leading to failure.

RUITO CONTROL METHOD

100% visual inspection per ASTM standards | X-ray inspection for high pressure classes | Test bar spectroscopy.

Dimensional Measurement

Gate 3: Machining Inspection

VERIFICATION ITEMS

Flange dimensions per ASME B16.5, sealing surface flatness, bore ID tolerances, thread inspection, surface roughness checks.

RISK IF SKIPPED

Flange mismatch preventing installation, gasket leakage due to poor flatness, excessive pressure drop from undersized bores.

RUITO CONTROL METHOD

CMM inspection on random samples | Surface roughness tester for sealing areas | Dimensional reporting available.

Coating Thickness Test

Gate 4: Coating Quality Check

VERIFICATION ITEMS

DFT measurement for thickness, holiday detection for pinholes, adhesion testing (cross-hatch/pull-off), visual appearance.

RISK IF SKIPPED

Premature corrosion from thin coating, localized attack at pinholes, coating delamination contaminating downstream process.

RUITO CONTROL METHOD

Digital DFT gauges with recorded data | Holiday detection at rated voltage | Batch records tracking cure conditions.

Pressure Testing Gauge

Gate 5: Pressure Testing

VERIFICATION ITEMS

Hydrostatic test to 1.5x design pressure, 30-min hold verification, visual leak check, relief valve function test (if applicable).

RISK IF SKIPPED

Catastrophic rupture in field, fugitive emissions from bad gaskets, assembly errors allowing bypass, safety liability.

RUITO CONTROL METHOD

Calibrated test bench with chart recorder | Defined test procedure (fill, hold, release) | Witness testing supported.

Final Inspection Checklist

Gate 6: Final Release

VERIFICATION ITEMS

Final dimensional check, accessories verification, nameplate accuracy, finish inspection, documentation package completeness.

RISK IF SKIPPED

Shipping wrong components, documentation errors blocking customs/installation, missing certificates delaying project.

RUITO CONTROL METHOD

Final inspection checklist vs order | Photo documentation before packing | QC Manager sign-off required for release.

Need third-party inspection or witness testing? We coordinate at no additional charge

Arrange Inspection

Certifications & Compliance Framework

Independent third-party verification providing assurance of quality systems and product conformance

ISO Quality Certification

ISO 9001:2015

Quality management system certification covering design, manufacturing, testing, and delivery of industrial valves and strainers.

Application Market Global / General Industrial
CE Marking Compliance

CE Marking (PED)

Pressure Equipment Directive (2014/68/EU) compliance for Categories I-III. Declaration of conformity issued with technical file.

Application Market European Union (EU)
WRAS Drinking Water Approval

WRAS Approval

Materials testing confirms no contamination or taste/odor transfer. Safe for potable water contact.

Application Market Municipal Water / UK

DNV Marine Certification

DNV Type Approval

Certification for marine and offshore applications. Design review and factory inspection verifying class compliance.

Application Market Offshore / Marine
API 6D Pipeline Standard

API 6D (Available)

Specification for pipeline valves. Meets design, manufacturing, and testing requirements for critical oil & gas service.

Application Market Oil & Gas Pipelines
Fire Safe Testing API 607

Fire Safe API 607

Valves required to maintain sealing integrity during and after fire exposure. Critical for hydrocarbon service.

Application Market Refineries / Petrochemical

Need certification documentation for your project compliance? We provide certified copies with all orders

Request Certificates

Customization Capability Levels

Three tiers of engineering flexibility — from parameter adjustments to fully custom designs

Standard Industrial Valves Inventory
LEVEL 1

Standard Config Modifications

Low Complexity
Suitable For

Minor deviations: Flange standards (DIN/ANSI), mesh size changes, adding drains/vents, special paint.

Engineering

No calculation required. Simple substitution of components or shop modifications.

Lead Time

3-5 Weeks

Technical Engineering Drawing
LEVEL 2

Semi-Custom Solutions

Medium Complexity
Suitable For

Significant mods: Non-standard dimensions, special material combos (e.g., Exotic Basket in CS Body), high temp.

Engineering

Sizing verification, compatibility analysis, and modified manufacturing drawings required.

Lead Time

6-10 Weeks

3D CAD Modeling
LEVEL 3

Fully Custom Engineered

High Complexity
Suitable For

Unique requirements: Proprietary designs, extreme pressures, custom geometries, legacy replacements.

Engineering

Full R&D cycle: 3D Modeling, FEA/CFD analysis, prototyping, and witness testing.

Lead Time

12-20 Weeks

Have a unique application requiring custom engineering? Share your requirements for a feasibility assessment

Submit Custom Request
RUITO Basket Strainer - Modules 16-18

Delivery Timeline & Supply Capability

Predictable lead times with production tracking — know exactly when your equipment arrives

Order Confirmed
Day 1
Engineering Review
3-5 Days
Production
2-4 Weeks
Testing
2-3 Days
Packing
1-2 Days
Shipment
Ready

Standard Stock (Immediate)

Inventory: DN50-DN200, PN16/Class 150 Cast Iron & Steel
Lead Time: 1-2 weeks (Assembly & Paint)

Custom Configurations

Process: Includes drawing approval & material procurement
Lead Time: 4-8 weeks total duration

Urgent Expedite

Capability: Dedicated fast-track line & overtime shifts
Lead Time: 7-14 days (Subject to material stock)
RUITO Warehouse Inventory
Ready to Ship
500+ standard units maintained in stock for rapid deployment.

Need a specific delivery date? Contact us to discuss production scheduling and expedite options

Request Delivery Schedule

Frequently Asked Questions

Quick answers to common technical and procurement questions

How do I determine the correct basket strainer size for my application?
Proper sizing requires three key parameters: flow rate (actual m³/h, not just pipe size), allowable pressure drop (typically 0.3-0.5 bar clean, 1.0-1.5 bar dirty), and debris characteristics (type, size, loading frequency). A general rule: basket strainer should be 1-2 sizes larger than pipe diameter for flows above 50 m³/h to maintain velocity under 3 m/s and adequate debris capacity. We provide free sizing calculations based on your operating data — simply provide flow rate, operating pressure/temperature, and media type for a properly engineered recommendation.
What is the difference between cast iron, carbon steel, and stainless steel strainers?
Cast iron offers the lowest cost and is ideal for fresh water, HVAC, and non-corrosive applications up to 120°C, but fails rapidly in acidic or high-chloride environments. Carbon steel provides higher pressure ratings (up to Class 600) and temperature capability (425°C) for steam and industrial process water, though requires coating for corrosion protection. Stainless steel (SS304/316L) delivers superior corrosion resistance for chemical service, seawater, and food/pharma applications where material purity and cleanability are critical. Material selection should be based on media chemistry and service life requirements, not just initial cost — a properly specified SS316L strainer lasting 20 years offers better value than replacing corroded carbon steel units every 3 years.
Can I visit your factory for inspection before placing an order?
Yes, we welcome factory visits and audits. Many customers conduct pre-qualification audits to verify manufacturing capabilities, quality systems, and compliance with ISO 9001 standards. We can arrange facility tours, process demonstrations, and meetings with engineering and quality teams. Additionally, we support witness testing during production where customers or third-party inspectors can verify dimensional measurements, material composition (PMI testing), and hydrostatic pressure testing. Please contact us at least 2 weeks in advance to schedule visits and coordinate witness points in the production timeline.
What documentation is included with each strainer order?
Every order includes a comprehensive documentation package: (1) Material certificates with heat numbers and chemical composition for pressure boundary components, (2) Hydrostatic test reports documenting test pressure and duration with QC signature, (3) Dimensional inspection reports for critical dimensions, (4) As-built drawings showing actual configuration supplied, (5) Operation and maintenance manual with installation guidelines and recommended service intervals, (6) Commercial documents (packing list, commercial invoice). Additional documentation available on request includes: PMI test reports, coating DFT measurements, welding procedures (WPS/PQR), third-party inspection certificates, compliance declarations (CE, ASME U-stamp).
How often should basket strainers be cleaned and maintained?
Cleaning frequency depends on debris load and allowable pressure drop. Install differential pressure gauges to monitor actual performance — clean when pressure drop reaches 1.0-1.5 bar or per plant procedures. Typical intervals: clean cooling water systems weekly to monthly, process water applications monthly to quarterly, clean services may extend to semi-annually. Maintenance includes: (1) Isolate and depressurize strainer, (2) Open cover and remove basket (5-10 minutes with quick-opening designs), (3) Clean basket with water jet or brush, inspect for damage, (4) Inspect gasket, replace if compressed or damaged (every 2-3 years typical), (5) Reinstall basket and close cover, verify proper seating, (6) Return to service and monitor for leaks. Annual inspection should verify body integrity, coating condition, and fastener tightness.
Do you provide installation and commissioning support?
We provide comprehensive installation guidance through detailed documentation including installation drawings, torque specifications, and commissioning procedures. Our technical team offers remote support via email, phone, or video call to answer installation questions and troubleshoot any issues during startup. For complex projects or special applications, we can recommend qualified local service partners in your region who can provide on-site installation supervision. While we do not directly provide on-site installation services internationally, we ensure you have all necessary technical information and support to achieve successful installation and commissioning.
What warranty coverage is provided on basket strainers?
Standard warranty is 18 months from shipment date or 12 months from commissioning, whichever occurs first. Warranty covers defects in materials and workmanship including casting defects, welding failures, coating defects, and component failures under normal operating conditions within specified design parameters. Warranty does not cover damage from improper installation, operation beyond design limits, inadequate maintenance, or normal wear items (gaskets, fasteners). In the event of a warranty claim, we provide technical analysis to determine root cause and offer repair, replacement, or credit as appropriate. Extended warranty programs available for critical applications — contact us for details on coverage terms and requirements.
Can replacement baskets be ordered separately for existing strainers?
Yes, replacement baskets and spare parts are available for RUITO strainers. We maintain common basket sizes and mesh configurations in stock for faster delivery. For replacement basket orders, please provide: (1) Original strainer model/serial number if available, (2) Strainer body size (DN or NPS), (3) Required mesh size or perforation specification, (4) Material preference (SS304, SS316L, etc.), (5) Quantity required. We can also manufacture replacement baskets for competitor strainers if you provide dimensional drawings or send us the existing basket for measurement. Typical lead time for stock baskets is 1-2 weeks; custom baskets 3-4 weeks. We also supply gasket kits, fastener sets, and other wear components.

Still have questions? Our technical team is ready to provide detailed answers

Ask Your Question
Ready to Eliminate Filtration Failures Module Ready to Eliminate Filtration Failures Module Ready to Eliminate Filtration Failures

Ready to Eliminate Filtration Failures and Reduce Maintenance Costs?

Partner with RUITO for engineered basket strainer solutions backed by 20+ years manufacturing excellence.

Engineered Quality Assurance

Free sizing calculations, material selection analysis, and ISO 9001 certified manufacturing with full traceability and witness testing available.

Proven Global Performance

60+ countries, 6,000+ installations operating reliably in offshore platforms, chemical plants, power generation, and water treatment facilities.

Responsive Support & Delivery

Direct engineering access, 24-hour response, realistic lead times based on actual capacity, and weekly production updates with photos.

Get Your Custom Solution

We respect your privacy. Your information will only be used to provide technical support and quotations.

Why Choose RUITO for Your Industrial Valve Solutions?

Get expert technical consultation and discover how our precision-engineered valves can optimize your industrial operations.

ISO 9001, CE, WRAS & DNV Certified
All products meet European and international standards with comprehensive certifications for critical applications.
24-Hour Technical Response Guarantee
Our experienced engineering team provides technical consultation and design solutions within 24 hours.
Fast Delivery & Flexible MOQ
Stock products ship in 5 days, custom solutions in 15-25 days. Minimum order just 10 units.
Custom Engineering Solutions
From standard products to complex custom designs, our R&D team creates solutions for your specific requirements.
99.5% Quality Reliability
Rigorous 6-step quality control process with 12-month warranty and 100% pressure testing on all products.
Global Export Experience
Successfully serving 150+ clients across Europe, North America, and Asia with full English documentation support.

Get Your Free Technical Consultation

Connect with our valve experts and receive personalized solutions for your industrial projects. No commitment required.

Submission issue? You can also contact us directly:
